Bridge 27 PHASE 1

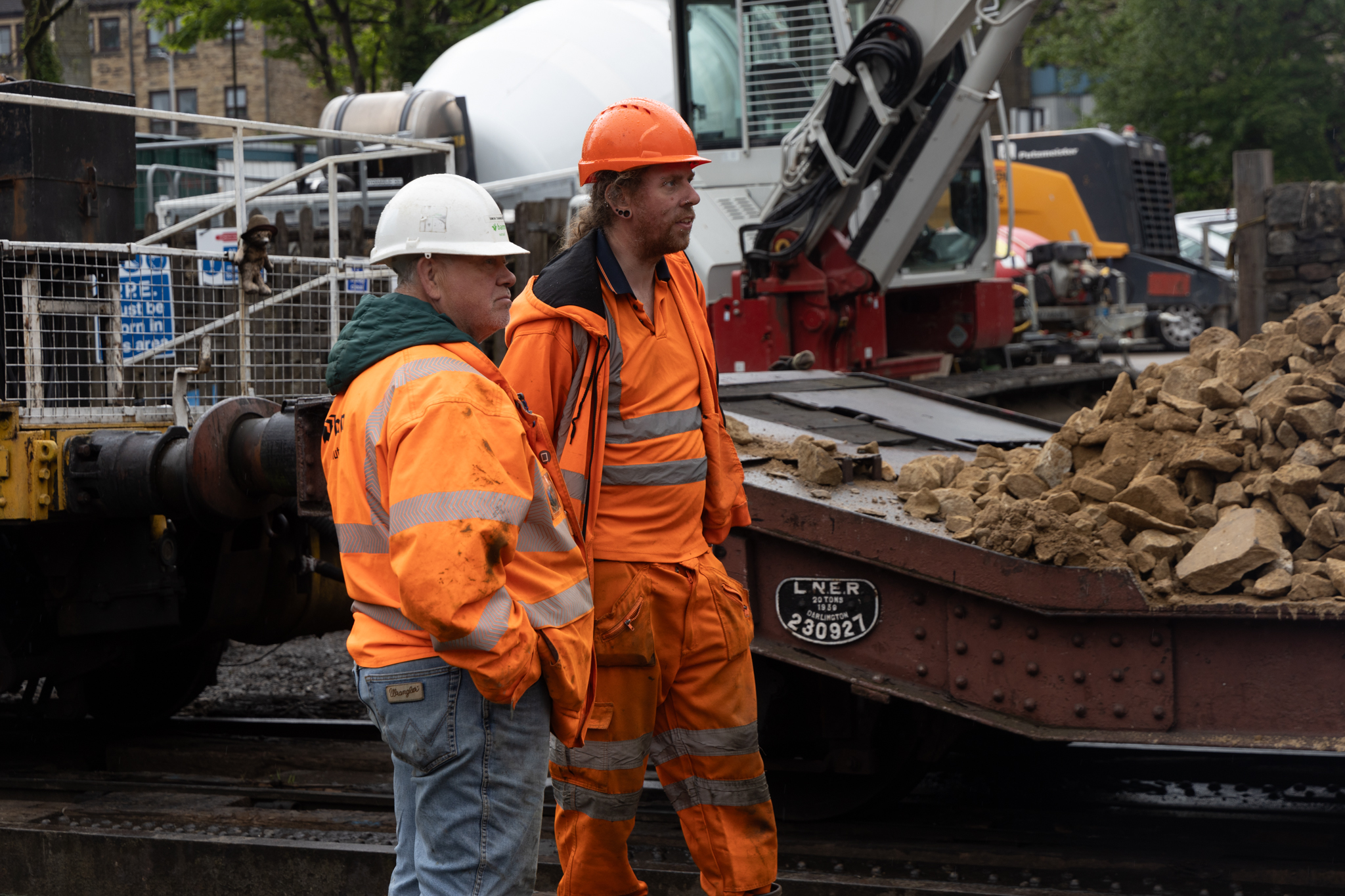

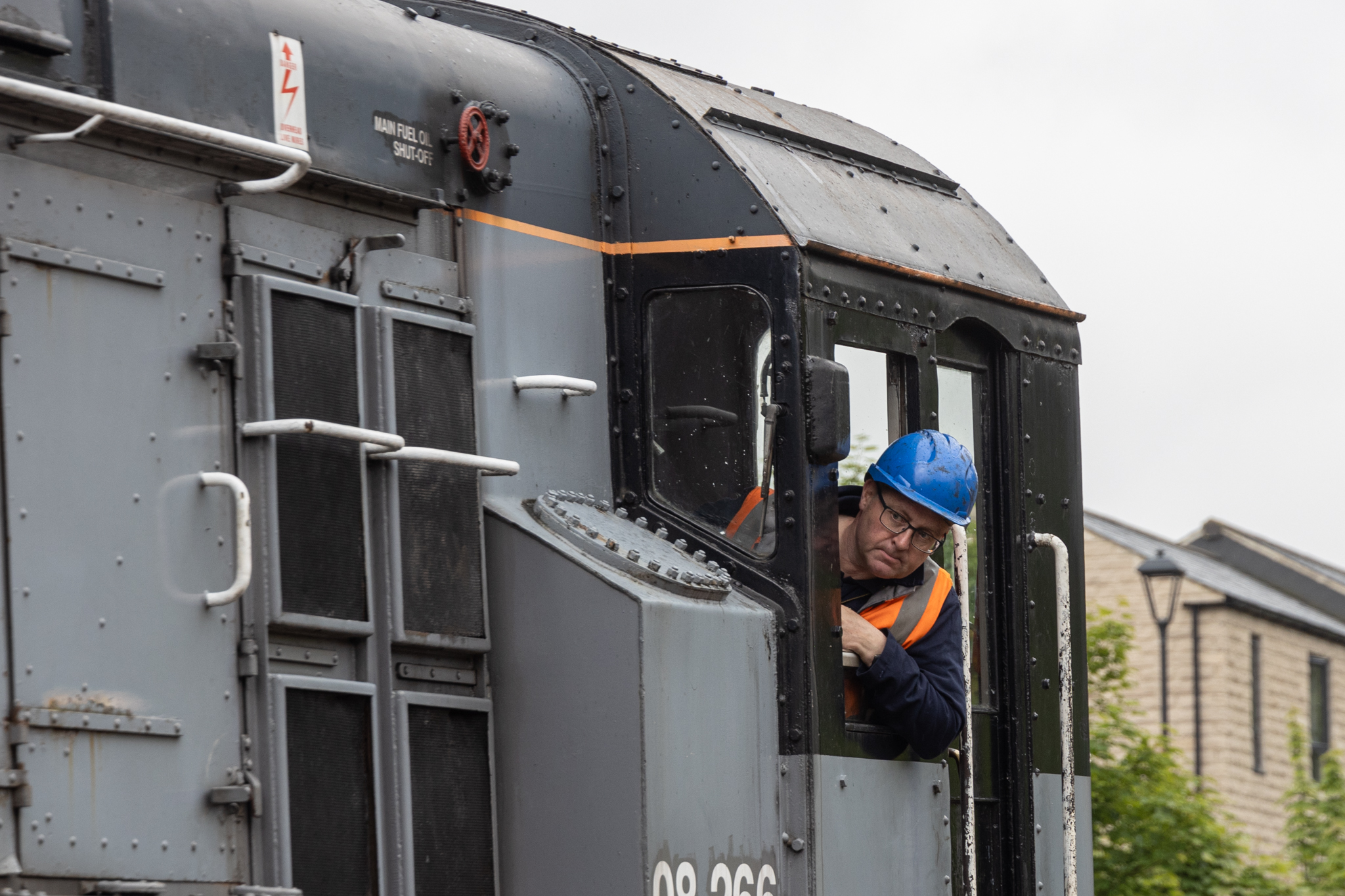

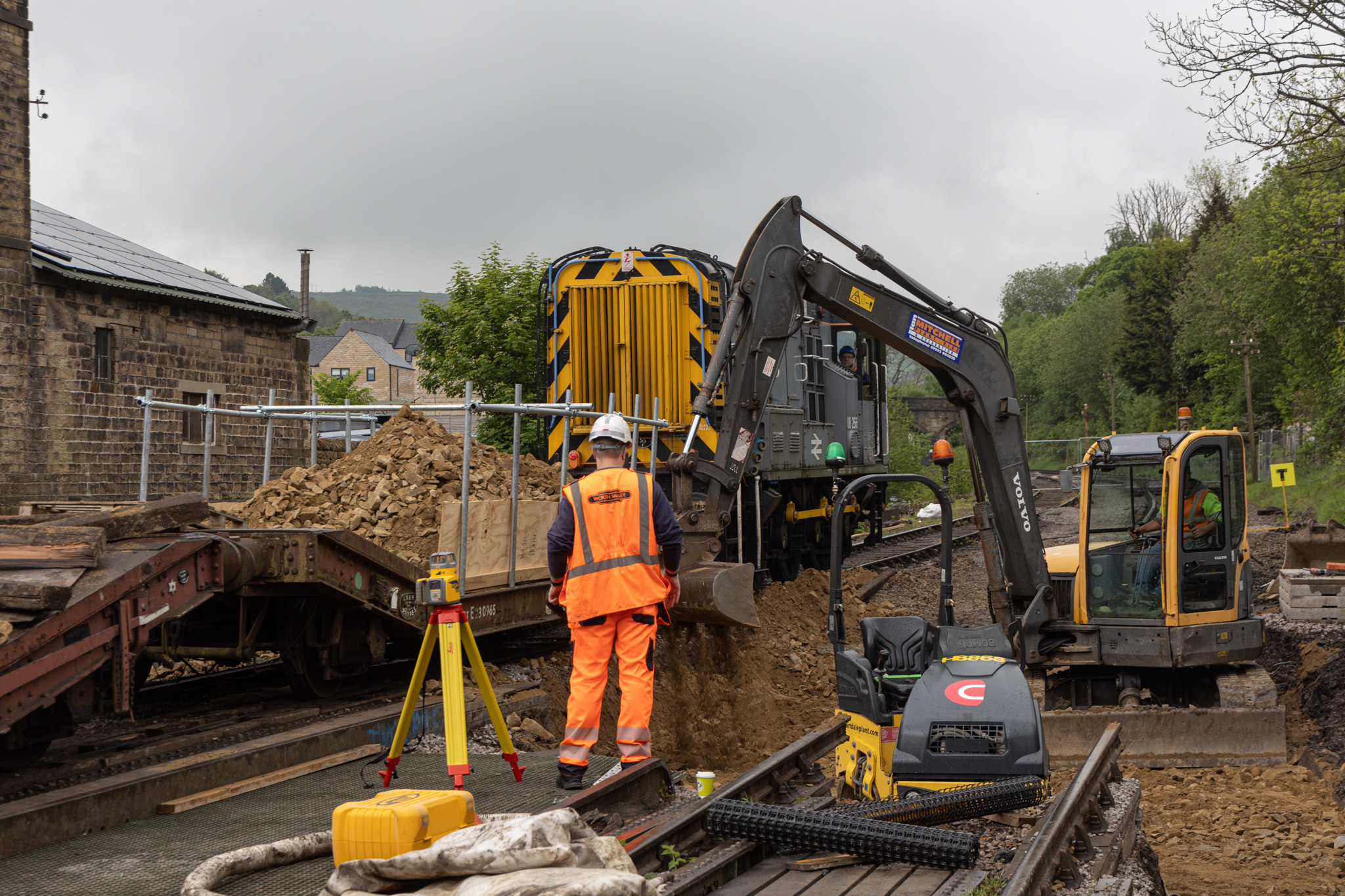

Piling Works have been progressing well with a breakdown-free day.

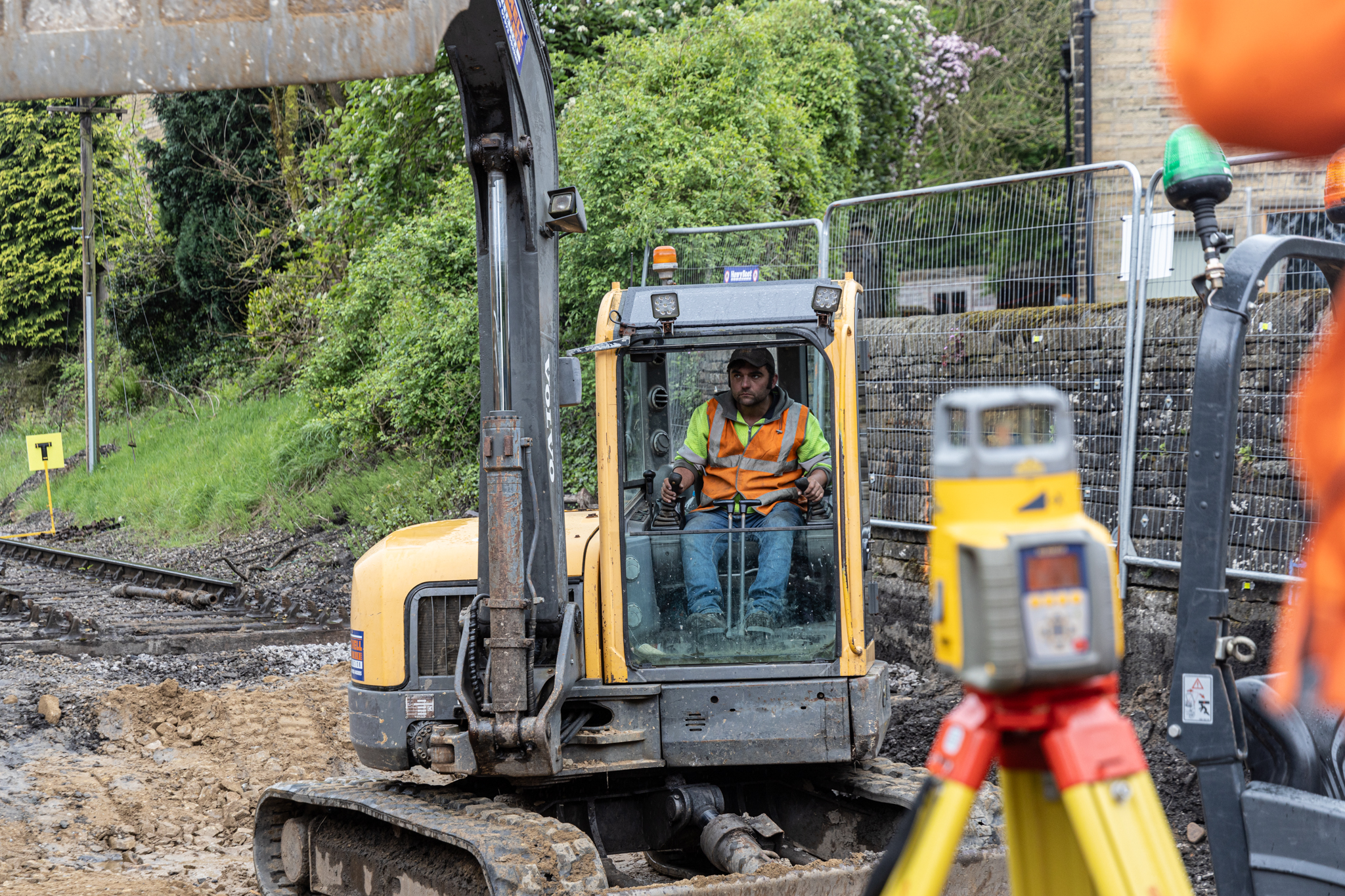

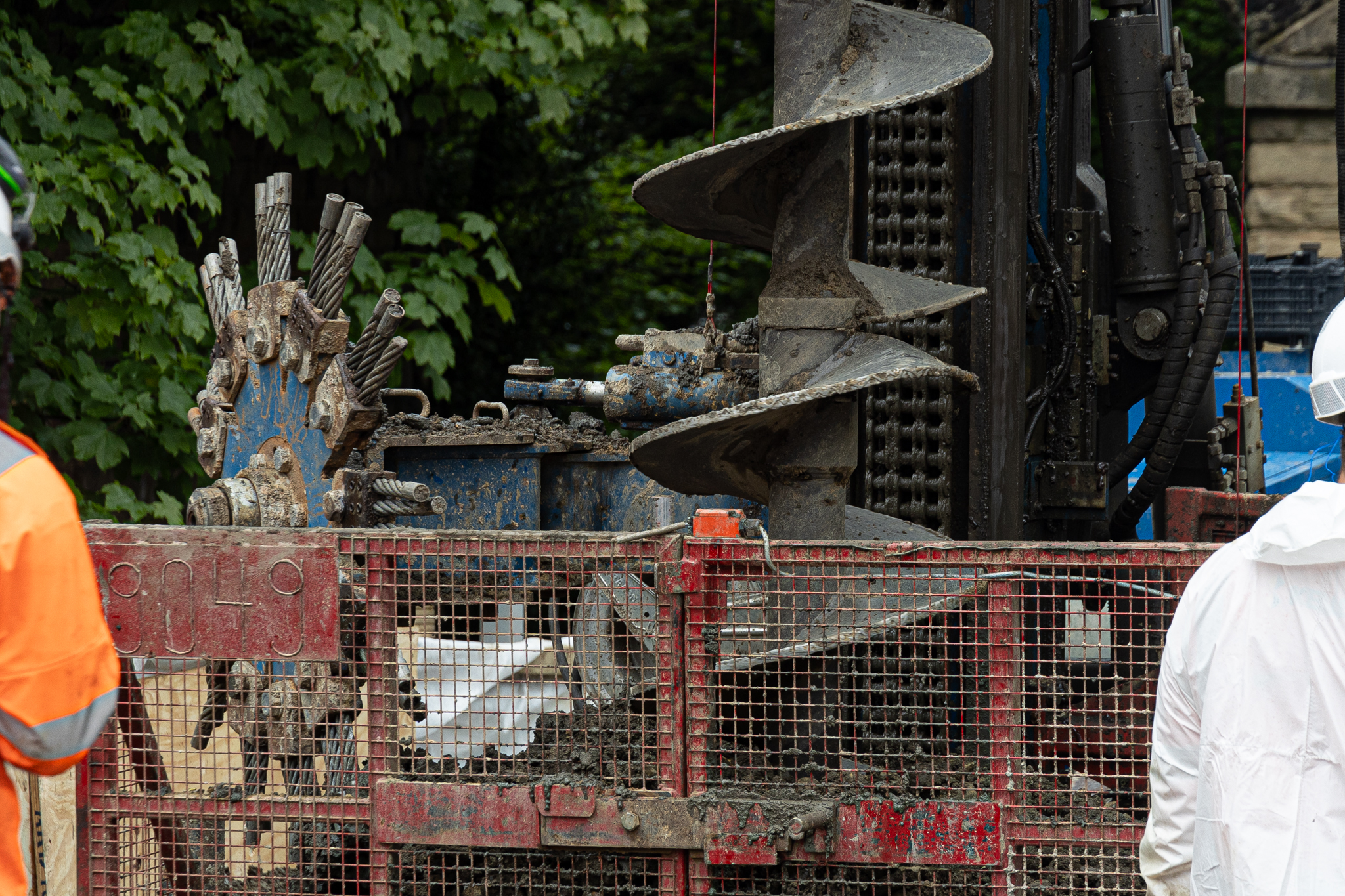

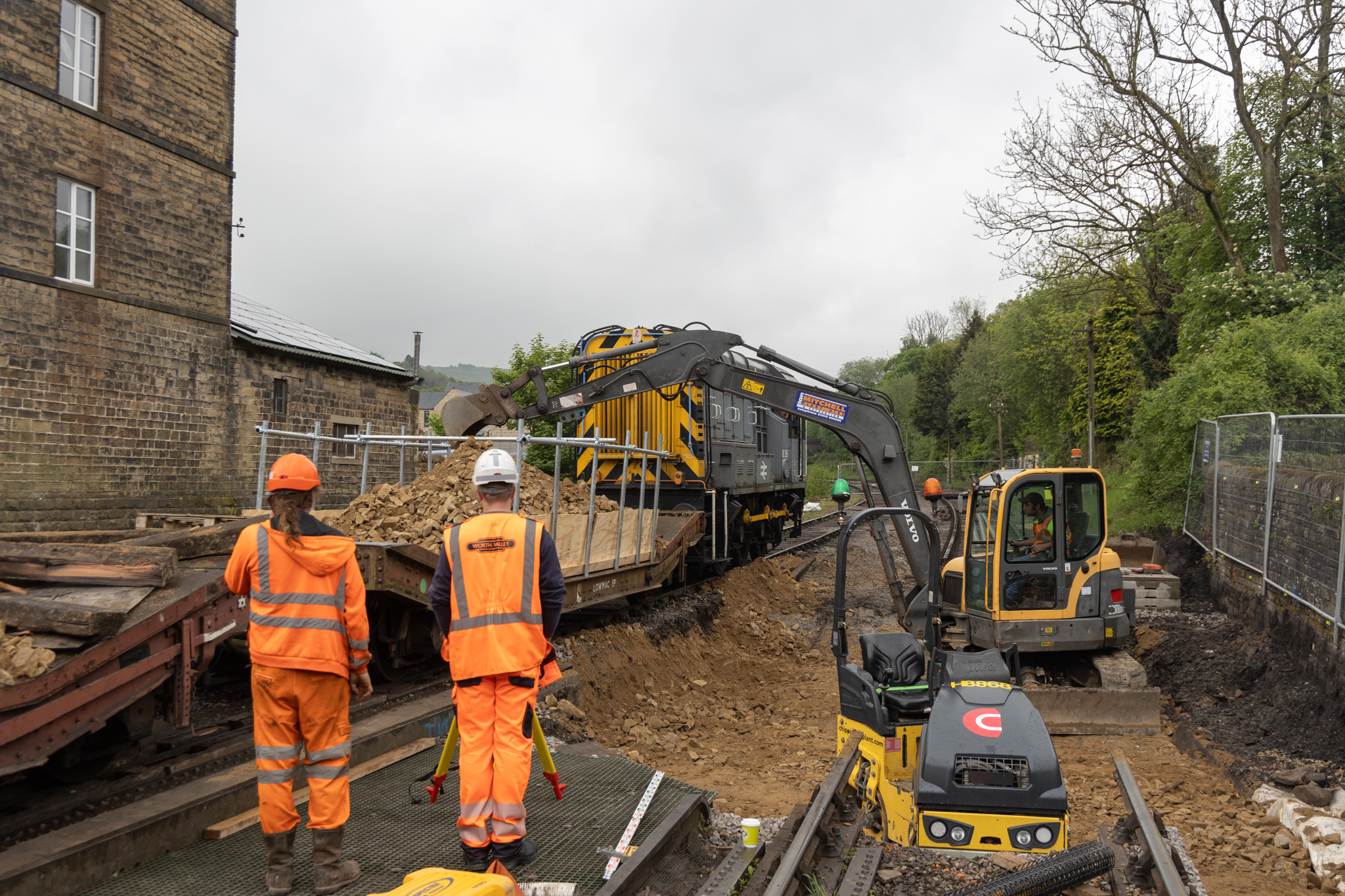

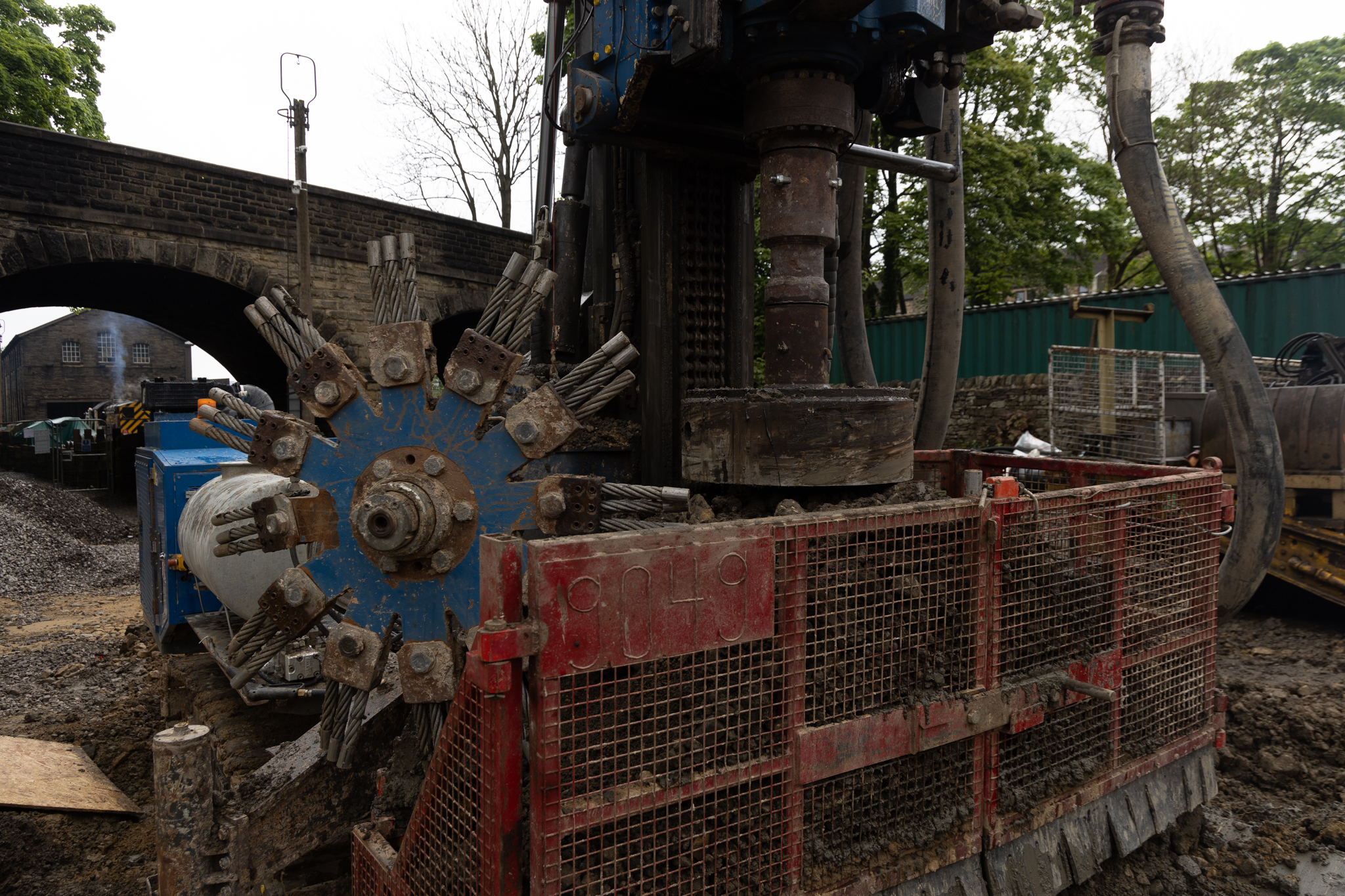

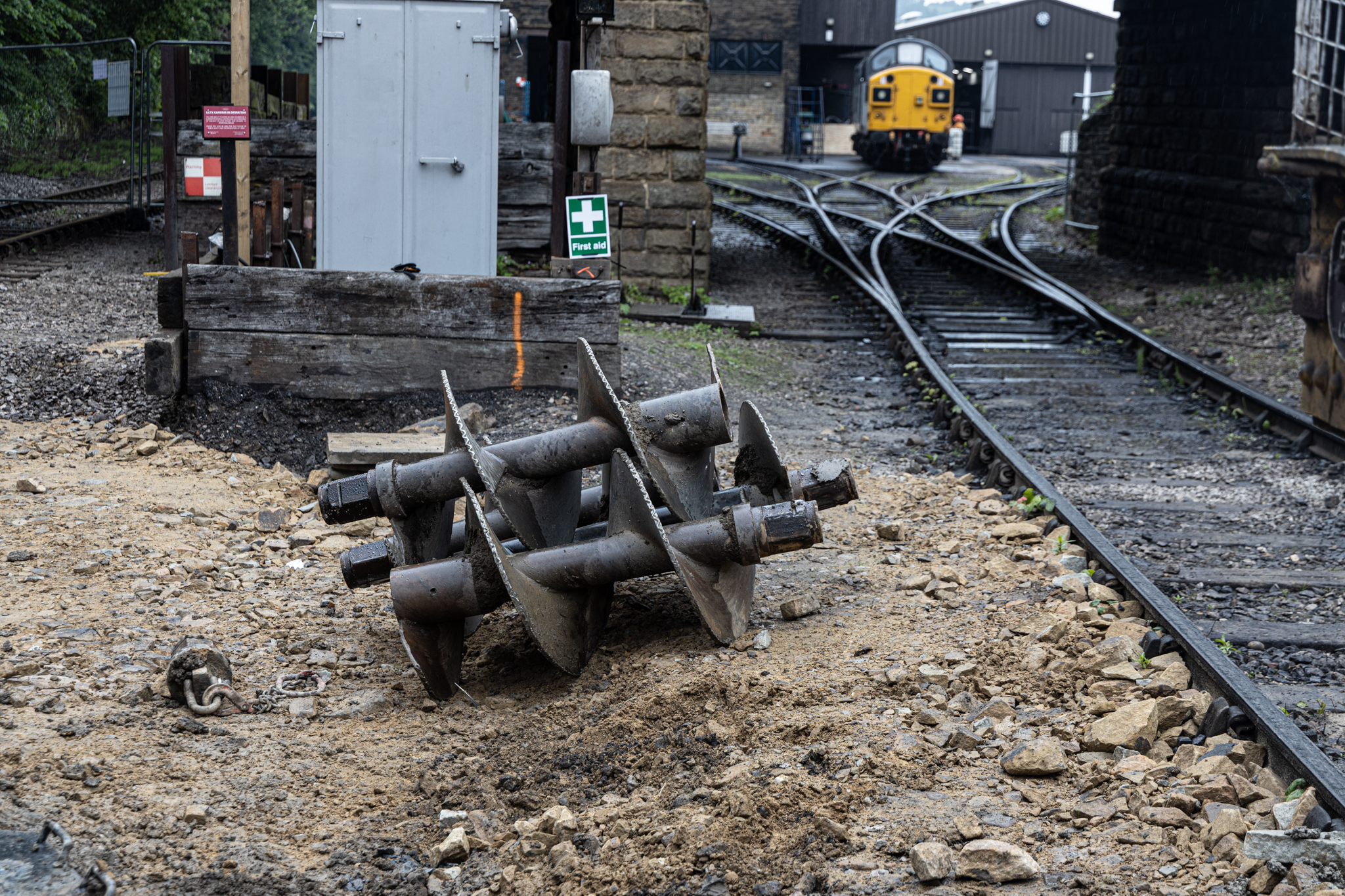

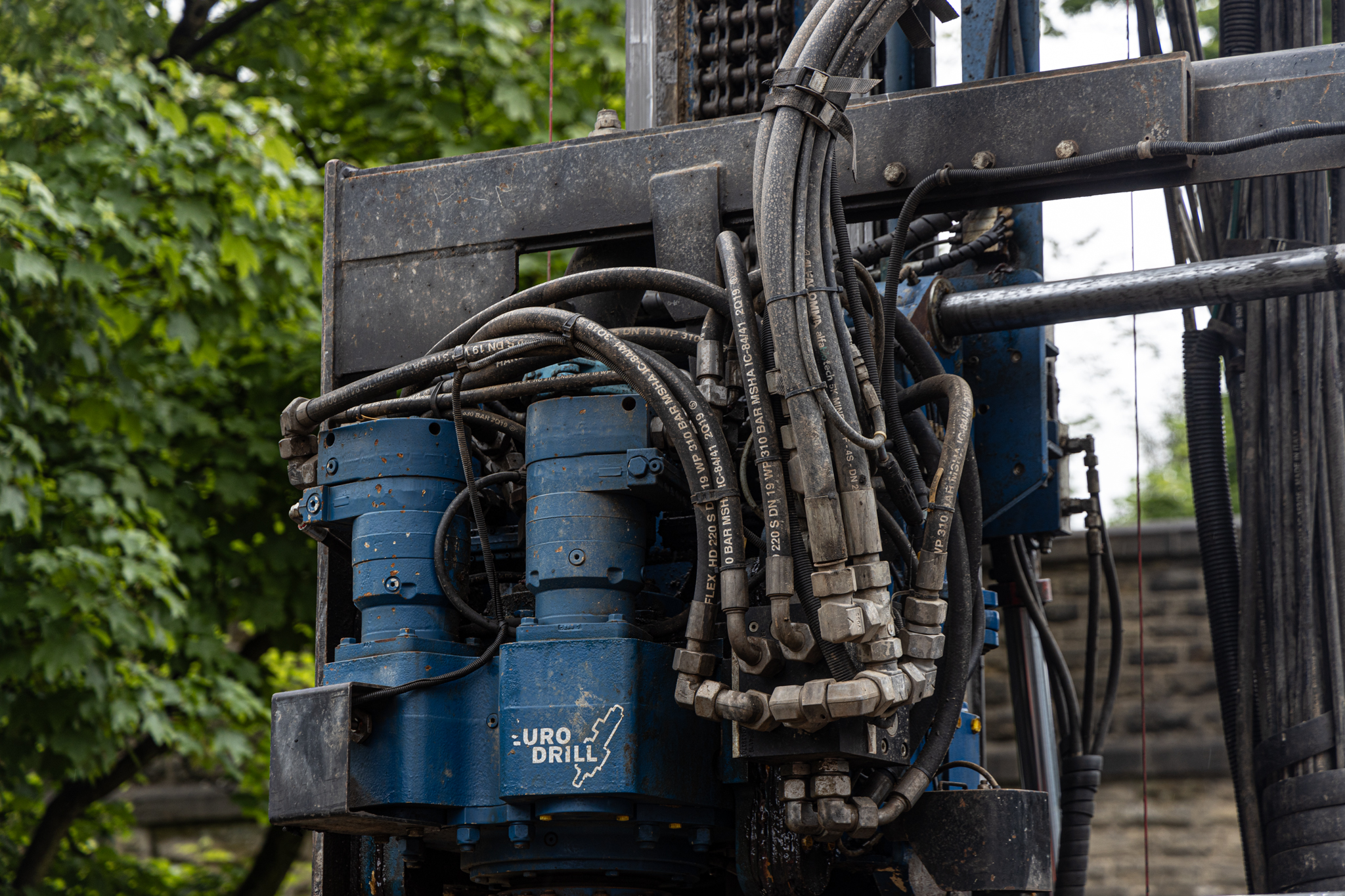

Four out of the six piles for the North side have been drilled, with one awaiting concreting. Work on the South Side Pile Mat is now on its fourth layer out of the five layers needed. The plan is now to try to reinstate the track tomorrow afternoon on this side to give us a head start for Friday.
